Zhejiang Natural Gas Pipeline Network

From Global Energy Monitor
Part of the
Global Gas Infrastructure Tracker,
a Global Energy Monitor project.
Download full dataset
Report an error
Related categories:

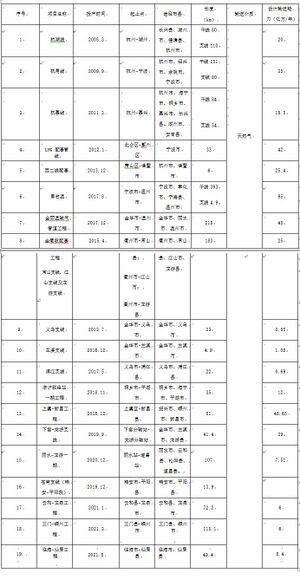

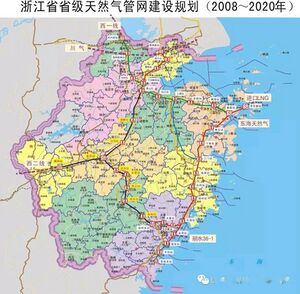

Zhejiang Natural Gas Pipeline Network 浙江天然气管网 is a pipeline network in China with segments that are proposed, in construction, and operating in Zhejiang Province, China.

Location

The network runs throughout Zhejiang Province, China.

Loading map...

Background

In February 2021, The People's Congress of Zhejiang Province released the "14th Five-Year Plan for Energy Development in Zhejiang Province" (浙江省能源发展十四五规划). With regards to natural gas development, the report notes that there is a total of 2,966 kilometers of natural gas pipelines across the province. The Province has seen an increase in natural gas usage since 2015, and there is particular attention on 'county-to-county' energy development, and an aim to connect increasingly rural and remote regions and villages to Zhejiang Province's growing natural gas infrastructure.[1][2]

This report was followed by the release of "Provincial Coal, Oil and Natural Gas 14th Five-Year Development Plan for Zhejiang Province" (浙江省煤炭石油天然气发展“十四五”规划) which specifically highlights natural gas pipeline projects that are key to this network and the expansion of natural gas pipelines in the province. This includes the Hangzhou-Jiaxing, Taizhou-Jinhua-Quzhou, Ningbo-Shaoxing, Ningbo-Shaoxing gas pipelines.[3] These projects join pre-existing and recently operational projects such as Jinhua-Lishui-Wenzhou, Ningbo-Taizhou-Wenzhou, Hangzhou-Ningbo, Hangzhou-Huzhou gas pipelines.


Zhejiang Energy Group Co., Ltd. (浙江省能源集团有限公司) has served as the leading developer and operator for this network. According to their corporate website, this network facilitates over 80% of natural gas for the province.[4]

On July 2022, PipeChina and Zhejiang Energy Group signed an agreement to integrate the natural gas pipeline assets of Zhejiang Province into the national pipeline network. According to the agreement, the two parties jointly established the National Pipeline Network Group Zhejiang Natural Gas Pipeline Network Co., Ltd., which will be the only constructional and operational entity of the natural gas pipeline in the province.

根据协议约定,双方合资成立国家管网集团浙江省天然气管网有限公司,将成为全省天然气管网的唯一建设运营主体,实现省内国家干线和支干线管道统一规划、统一建设、统一运营、统一管理和统一运价,为各类资源主体和下游市场用户提供公平开放、公平竞争的服务平台。.[5]

Network details

Shangyu-Xinchang Gas Pipeline 上虞-新昌输气管道

  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity: 0.49 billion cubic meters per year[6]
  • Length: 83.2 km[6]
  • Diameter: 813 mm[6]
  • Status: Operating[7]
  • Start year: 2017[7]
  • Cost: 0.25 billion RMB[8]
Loading map...

Xiaoshan-Yiwu Natural Gas Pipeline 萧山-义乌天然气管道

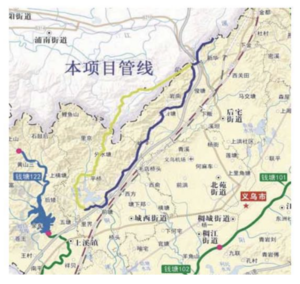

  • Xiaoshan-Yiwu gas pipeline.png
    Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司[9]
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity: 4.5 billion cubic meters per year[9]
  • Length: 122 km[9]
  • Diameter: D813mm/606mm[10]
  • Status: Operating[11]
  • Start year: 2022[11]
  • Cost: 1.67 billion RMB[9]
Loading map...

Lishui-Longyou Pipeline 丽水-龙游输气管道

  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity: 0.75 billion cubic meters per year[12]
  • Length: 107.13 km[13]
  • Diameter: D813mm/D406mm[14]
  • Status: Operating[14]
  • Start year: 2020[14]
  • Cost: 1.23 billion RMB[13]
Loading map...

Hangzhou-Jiaxing Gas Pipeline 杭嘉输气管道(杭州-嘉兴)

  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd.国家管网集团浙江省天然气管网有限公司[15]
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity: 2.7 bcm/y[15]
  • Length: 87.7 km[15]
  • Diameter: 813 mm[15]
  • Status: Operating[15]
  • Start year: 2010[15]
  • Cost: 1286 million RMB[15]
Loading map...

Sanmen-Shengzhou Gas Pipeline 三门-嵊州输气管道

Diagram of Sanmen-Shengzhou Gas Pipeline
  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity: 0.90 billion cubic meters year
  • Length: 116.20 km[16]
  • Diameter: D813mm[16]
  • Status: Construction[17]
  • Construction year: 2018[17]
  • Start year:
  • Cost: 1.29 billion RMB[17]

The pipeline's source is the West-East Gas Pipeline 1.

Loading map...

The pipeline runs from Sanmen, Taizhou, to Shengzhou, Shaoxing Zhejiang, China.[17]

Taizhou-Jinhua-Quzhou Natural Gas Pipeline 台金衢天然气干线(台州-金华-衢州)

  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity:
  • Length: 200 km[18]
  • Diameter: D1016mm[18]
  • Status: Proposed[18]
  • Start year:
  • Cost:
Loading map...

Yongshao Gas Pipeline (East and West Sections) 甬绍干线天然气管道 (东段, 西段)

Loading map...
  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity:
  • Length: 232 kilometers
  • Diameter: 1219 millimeters
  • Status: Construction[19]
  • Construction year:
  • Cost: 6 billion RMB


This pipeline is being developed in two sections, and the details above are the sum of the sections below.

East Section (Zhongzhai-Xinchang) 东段 (中宅-新昌)

  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity:
  • Length: 147 km[18]
  • Diameter: D1219mm[18]
  • Status: Construction[19]
  • Construction year: 2021[18]
  • Cost: 3.8 billion RMB[18]

West Section (Xinchang-Zhuji) 西段 (新昌-诸暨)

  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity:
  • Length: 85 km[18]
  • Diameter: D1219mm[18]
  • Status: Proposed[20]
  • Construction year:
  • Cost: 2.2 billion RMB[18]

Yunhe-Longquan Gas Pipeline 云和-龙泉输气管道

  • Operator: Zhejiang Provincial Natural Gas Development Co., Ltd.
  • Parent company: Zhejiang Energy Group Co., Ltd. 浙江省能源集团有限公司
  • Capacity: 0.6 billion cubic meters per year[21]
  • Length: 72.2 km[21]
  • Diameter:
  • Status: Operating[21]
  • Start year: 2021[21]
  • Cost: 1 billion RMB[22]

The pipeline runs from Yunhei in Zhejiang province to Longquan in Zhejiang province.[23]

Loading map...

The project was permitted by Zhejiang Province Development and Reform Committee in June 2017.[24] Construction of the pipeline began in March, 2018.[23][25]

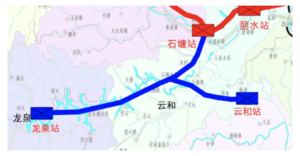

Diagram of Yunhe-Longguan Gas Pipeline

In January 2021, the pipeline began operating.[26]

"县县通”云和-龙泉天然气管道工程全长72.2公里,设计压力6.3兆帕,起于丽水市云和县石塘镇,终于丽水市龙泉市、云和县,沿途新建2座分输站、1座清管站、2座线路截断阀室,通气后预计每年为龙泉市、云和县两地输送约6亿立方米的天然气能源."[26]

该项目总投资约11.0379亿元,起于云和县石塘阀室,途径云和县紧水滩镇、浮云街道、凤凰山街道、白龙山街道,到达崇头镇崇头阀室,在崇头阀室分为两路,一路止于云和县白龙山街道的云和分输站,另一路途径龙泉市安仁镇,止于龙泉市塔石街道的龙泉分输站。管道设计年输气量6亿方.[24]

Yunhe-Jingning-Wencheng-Taiwhun Natural Gas Pipeline 云和-景宁-文成-泰顺输气管道

The project was shelved in 2019[27]. And in 2021, it was listed into Provincial Coal, Oil and Natural Gas 14th Five-Year Development Plan.[3] The planned construction year will be 2022-2025.[3]

  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity:
  • Length: 115 km[3]
  • Diameter: D406mm[3]
  • Status: proposed[3]
  • Construction year: 2022[3]
  • Cost: 1.5 billion RMB[3]
Loading map...

Changzhou-Huzhou Gas Pipeline 常长输气管道 (常州-湖州)

  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity: 1.79 billion cubic meters per year[28]
  • Length: 100.1 km[28]
  • Diameter:
  • Status: Operating[28]
  • Start year: 2003[28]
  • Cost:
Loading map...

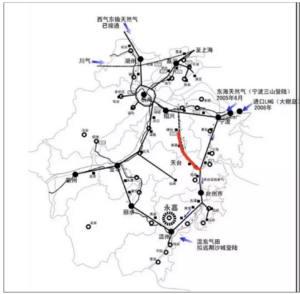

The pipeline's source is the West-East Gas Pipeline 1.

Chunxiao-Ningbo Offshore Gas Pipeline 春晓-宁波海上输气管道

  • Owner:
  • Parent company: CNOOC and Sinopec[29]
  • Capacity: 2.5 billion cubic meters per year
  • Length: 350 km[29]
  • Diameter:
  • Status: Operating
  • Start year: 2006
  • Cost:

The pipeline runs from the East Sea to Beilun, Ningbo, Zheijiang, China.

Loading map...


The source of the pipeline is the offshore Chunxiao gas and oil field.[30] The development of the Chunxiao gas field is disputed between Japan and China, since the location is near the offshore boundary between the two countries.[31]

Hangzhou-Huzhou Gas Pipeline 杭湖输气管道 (杭州-湖州)

  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity: 2 billion cubic meters per year[32]
  • Length: 190 km[32]
  • Diameter: 813 mm (the trunk line)[33]
  • Status: Operating[32]
  • Start year: 2005[32]
  • Cost:

The pipeline runs from Hangzhou, Zhejiang to Huzhou, Zhejiang.

Loading map...

Hangzhou-Ningbo Gas Pipeline 杭甬输气管道 (杭州-宁波)

  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd.浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity: 3.5 billion cubic meters per year[34]
  • Length: 331 km[34]
  • Diameter: 813 mm[35]
  • Status: Operating[34]
  • Start year: 2009[34]
  • Cost:

The pipeline runs from Hangzhou, Zhejiang to Ningbo, Zhejiang.

Loading map...

Hangzhou-Ningbo Double Line Natural Gas Pipeline 杭甬复线天然气管道

  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity:
  • Length: 190 km[3]
  • Diameter: D1016mm[3]
  • Status: Construction[36]
  • Start year:
  • Cost: 3.8 billion RMB[3][36]
Loading map...

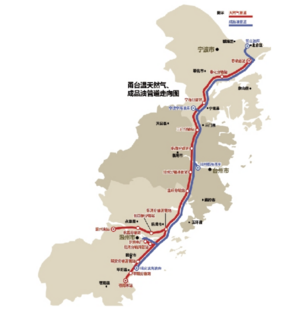

Ningbo-Taizhou-Wenzhou Gas Pipeline 甬台温输气管道 (宁波-台州-温州)

Diagram of Ningbo-Taizhou-Wenzhou Gas Pipeline
  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity: 9.5 billion cubic meters per year[37]
  • Length: 430 km[37]
  • Diameter: 813 mm[38]
  • Status: Operating[39]
  • Start year: 2017[39]
  • Cost: 5600 million RMB[40]

The pipeline runs from Ningbo, through Taizhou, to Wenzhou in Zhejiang Province, China.

Loading map...

The pipeline's source is Chunxiao Offshore oil and gas, as well as imported LNG in Ningbo. The construction began in 2012 and took five years to complete. A refined oil pipeline was built at the same time and was running a similar route.[37]

Ningbo-Taizhou-Wenzhou Gas Pipeline Cangnan Branch 甬台温天然气输气管道工程苍南支线

Loading map...

Jinhua-Lishui-Wenzhou Gas Pipeline 金丽温输气管道 (金华-丽水-温州)

  • Operator:
  • Owner: Zhejiang Zheneng Natural Gas Pipeline Network Co., Ltd. 浙江浙能天然气管网有限公司
  • Parent company: Zhejiang Provincial Energy Group Co., Ltd.
  • Capacity: 4.5 billion cubic meters per year
  • Length: 220.2 km[22][43]
  • Diameter: 813mm[43]
  • Status: Operating[43]
  • Start year: 2018[44]
  • Construction year: 2015[43]
  • Cost: 3200 million RMB[45]
Loading map...

The pipeline's sources are the Ningbo-Taizhou-Wenzhou Gas Pipeline and the Hangzhou-Jinhua-Quzhou Gas Pipeline. Together, these three pipelines plus Hangzhou-Ningbo Gas Pipeline form a major loop line within Zhejiang Province.

Jinhua-Lishui-Wenzhou Gas Pipeline Jinqu Section Yiwu Branch 金丽温省级天然气管道金衢段配套管道工程义乌支线项目

  • Operator:
  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd.Operating[46]
  • Parent company:
  • Capacity: 0.499 billion cubic meters per year[47]
  • Length: 32.2 km[47]
  • Diameter: 660 mm[47]
  • Status: Operating[46]
  • Start year: 2013[46]
  • Cost: 259.49 million RMB[47]
Loading map...

Jinhua-Lishui-Wenzhou Gas Pipeline Jinqu Section Changshan Branch, Jiangshan Branch and Longyou Branch 金丽温省级天然气管道金衢段配套管道工程常山支线、 江山支线及龙游支线项目

  • Operator:
  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd.[46]
  • Parent company:
  • Capacity: 0.355 billion cubic meters per year[48]
  • Length: 134 km[48]
  • Diameter: 355.6 mm[48]
  • Status: Operating[46]
  • Start year: 2015[46]
  • Cost: 568 million RMB[48]
Loading map...

Jinhua-Lishui-Wenzhou Gas Pipeline Jinqu Section Jinhua Gas Turbine Branch, Lanxi Branch 金丽温省级天然气管道金衢段配套管道工程金华燃机支线及兰溪支线项目

  • Operator:
  • Owner: Zhejiang Zheneng Natural Gas Pipeline Network Co., Ltd.[49]
  • Parent company:
  • Capacity: 0.965 billion cubic meters per year[49]
  • Length: 46.663 km[49]
  • Diameter: 813/323.9 mm[50]
  • Status: Operating (Lanxi Branch)[46]; Construction completed on June 2014 (Jinhua Gas Turbine Branch)[51]
  • Start year: 2016[46]
  • Cost: 249 million RMB[49]
Loading map...

Jinhua-Lishui-Wenzhou Gas Pipeline Jinqu Section Pujiang Branch, Dongyang Branch 金丽温省级天然气管道金衢段配套管道工程浦江支线及东阳支线项目

  • Operator:
  • Owner: Zhejiang Zheneng Natural Gas Pipeline Network Co., Ltd.[46]
  • Parent company:
  • Capacity: 0.159 billion cubic meters per year[52]
  • Length: 46.663 km[52]
  • Diameter: 406.4/355.6 mm[52]
  • Status: Operating (Pujiang Branch)[46]; (Dongyang Branch)[53]
  • Start year: 2017 (Pujiang Branch)[46]; 2018 (Dongyang Branch)[53]
  • Cost: 351 million RMB[52]
Loading map...

Qushan LNG Transport Pipeline 衢山LNG接收站外输管道

  • Owner:
  • Parent company:
  • Capacity:
  • Length: 110 kilometers[54]
  • Diameter: 1016 mm[54]
  • Status: Proposed[54]
  • Start year:
  • Cost: 5 billion RMB[54]
Loading map...

The pipeline starts at the Qushan LNG Terminal, carrying imported LNG from Qushan Island elsewhere within Ningbo, Zhejiang Province, China.

Zhoushan LNG Underwater Transport Pipeline 新奥舟山LNG接收站外输海底管道

  • Owner: ENN (Zhoushan) Natural Gas Pipelines Co., Ltd. 新奥(舟山)天然气管道有限公司
  • Parent company: ENN Natural Gas Co., Ltd. 90%; PRISM ENERGY INTERNATIONAL PTE. LTD. 10%
  • Capacity: 8 billion cubic meters per year[55]
  • Length: 81 kilometers[55]
  • Diameter: 1016 millimeters[55]
  • Status: Operating[55]
  • Start year: 2020[55]
  • Cost: 8 billion RMB[55]
Loading map...

The pipeline carries gas from Zhoushan to Ningbo in Zhejiang Province, China.

Longquan-Qingyuan Branch 庆元支线(龙泉-庆元)

  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity:
  • Length: 60 km[6]
  • Diameter: 406 mm[6]
  • Status: proposed[56]
  • Start year:
  • Cost: 700 milliom RMB[57]
Loading map...

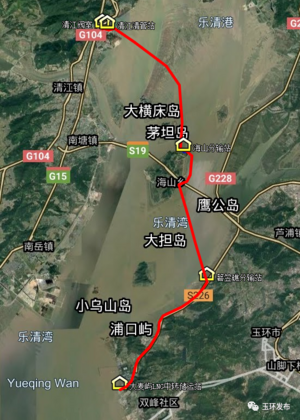

Yueqing-Wenzhou Gas Pipeline 乐清-温州输气管道

  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity:
  • Length: 46 km[6]
  • Diameter: 1219 mm[6]
  • Status: proposed[54]
  • Start year:
  • Cost:
Loading map...

Zhejiang-Shanghai Connecting Pipeline (Tongxiang-Shanghai) Phase I & II 浙沪输气联络线(桐乡-海盐-上海)

The pipeline is an important part of the natural gas pipeline network in Zhejiang Province and an important trunk line to ensure the emergency supply of natural gas in Zhejiang and Shanghai.[58]The pipeline was built with Phase I & II.

  • Owner: Zhejiang Provincial Natural Gas Development Co., Ltd. 浙江省天然气开发有限公司
  • Parent company: PipeChina 60%, Zhejiang Energy Group 40%
  • Capacity: 0.118 bcm/y(Phase I)[59]; 0.8 bcm/y(Phase II)[60]
  • Length: 34.54 km(Phase I)[59]; 45.8 km(Phase II)[60]
  • Diameter: 813 mm (Phase I and Phase II)[59][60]
  • Status: Operating (Phase I)[61]; Construction[62]
  • Start year: 2018 (Phase I)[63]
  • Cost: 413.0432 million RMB[59]; 634 million RMB[60]
  • Associated infrastructure: Hangzhou-Jiaxing Gas Pipeline[58]
Loading map...

Wenzhou LNG Terminal Export Pipeline 温州LNG外输管道

The pipeline can not only meet the gas demand of Wenzhou, but also effectively make up for the lack of supply and peak-shaving capacity of the Zhejiang gas pipeline network, and provide reliable energy guarantee for the safe supply of natural gas, emergency reserves and sustainable economic development.[64]

  • Owner: Zhejiang Provincial Energy Group Co., Ltd. 浙江省能源集团有限公司
  • Parent company:
  • Capacity:
  • Length: 26 km[65]
  • Diameter: 1016 mm[65]
  • Status: Construction (Completed on June 2023)[66]
  • Start year:
  • Cost: 600 million RMB[65]
  • Associated infrastructure: Wenzhou LNG Terminal[64]
Loading map...

Wenzhou Huagang LNG Terminal Export Pipeline 温州华港LNG项目外输管道

Loading map...

Dongyang-Pan'an Gas Pipeline 东阳-磐安天然气工程

Loading map...

Jiaxing Connection Pipeline Between West-East Gas Pipeline 2 and Sichuan-Shanghai Gas Pipeline 西二线、川气东送嘉兴联通工程

This pipeline is a key project of China's oil and gas infrastructure in 2021. It can realize the interconnection between West-East Gas Pipeline 2 and Sichuan-to-Shanghai Gas Pipeline.[69]

Loading map...

Liuheng-Chunxiao Gas Pipeline 六横-春晓天然气管道

The Liuheng-Chunxiao Gas Pipeline is one of the key tasks of the "14th Five-Year Plan" for the development of coal, oil and natural gas in Zhejiang Province. It is the main natural gas delivery channel of Liuheng LNG Terminal and is planned to be connected to the provincial pipeline network Yongshao Gas Pipeline.[71]

Loading map...

Yuhuan Damaiyu LNG Terminal Export Pipeline 玉环大麦屿LNG站外输管道

The pipeline is one of the key tasks of the "14th Five-Year Plan" for the development of coal, oil and natural gas in Zhejiang Province.[3]



Loading map...

Jiaxing LNG Terminal Export Pipeline 嘉兴LNG站外输管道

The pipeline is one of the key tasks of the "14th Five-Year Plan" for the development of coal, oil and natural gas in Zhejiang Province.[3]

Loading map...

Toumen Port LNG Terminal Export Pipeline 头门港LNG接收站外输管道

The pipeline is one of the key tasks of the "14th Five-Year Plan" for the development of coal, oil and natural gas in Zhejiang Province.[3]

Loading map...

Taizhou-Jinhua-Quzhou Gas Pipeline 台金衢天然气干线

The pipeline is one of the key tasks of the "14th Five-Year Plan" for the development of coal, oil and natural gas in Zhejiang Province.[3]

  • Operator:
  • Owner:
  • Parent company:
  • Capacity:
  • Length: 200 km[3]
  • Diameter: 1016 mm[3]
  • Status: Proposed[54]
  • Start year:
  • Cost: 5000 million RMB[3]
  • Associated infrastructure:
Loading map...

浙江省“十四五”煤炭、石油、天然气重大项目表 (Table of Major Coal, Oil and Nutural Gas Projects in Zhejiang Province For 14th Five-Year-Plan Period)

[79]

序号 项目名称 建设内容 建设年限 项目总投资

(亿元)

建设地点
一、建成项目
1 大镇复线(原油管道) 大榭岛-岚山,长度约62公里,管径864mm,设计压力6.5MPa 2023-2025 25 宁波
2 黄泽山-鱼山原油海底管道 长度为46公里,输送量3000万吨/年 2021-2022 16 舟山
3 外钓—册子原油管道 长度约3.5公里,双管,输送量4000万吨/年 2024-2025 2.7 舟山
4 金塘—册子原油管道 长度为10.5公里,3管,输送量6000万吨/年 2021-2025 11 舟山
5 册子—马目原油管道 长度为9.8公里,双管,输送量4000万吨/年 2020-2022 7.2 舟山
6 舟山—宁波成品油管道(海管) 自舟山鱼山岛,至宁波登陆,线路总长约52公里 2021-2022 8.8 舟山、宁波
7 甬绍杭成品油管道 自宁波登陆点,经绍兴至余杭仁和油库(其中部分利用已建绍杭管道),线路总长约268公里 2021-2024 30 宁波、绍兴、杭州
8 鱼山岛—黄泽山作业区成品油管道 起自舟山鱼山岛,至黄泽山作业区,线路总长约35公里 2023-2025 7 舟山
9 黄泽山石油中转储运工程二期项目 油库规模104万立方米 2020-2022 12.6 舟山岱山
10 舟山中际化工油品储运基地 油库规模60万立方米 2019-2021 5.7 舟山定海
11 盛达燃料油中转加注基地项目 油库规模79.4万立方米 2019-2022 20 舟山六横
12 光汇油品储运项目

(北岛)

油库规模116万立方米 2010-2023 9.6 舟山定海
13 金塘石油储运基地 油库规模480万立方米 2022-2025 45 舟山金塘
14 中奥能源油品储运扩建工程 油库规模87.6万立方米 2016-2021 23 舟山六横
15 华泰东白莲岛油品储运工程(一期) 油库规模82.4万立方米 2014-2023 19 舟山普陀
16 中化兴中六期扩建项目 油库规模41万立方米 2020-2021 6.6 舟山新城
17 黄泽山地下水封洞库项目 油库规模670万立方米 2022-2025 47 舟山岱山
18 黄泽山三期项目 黄泽山岛北部区域建设200万方以上的油库 2022-2025 20 舟山
19 岙山岛地下油品储运库 油库规模300万立方米 2022-2025 22 舟山临城
20 大榭原油地下洞库(一期) 油库规模300万立方米 2022-2025 35 宁波大榭
21 小衢山油品储运基地 油库规模300万立方米 2022-2025 55 舟山小衢山
22 宁波成品油基地(一期) 油库规模44万立方米 2019-2022 8.5 宁波北仑
23 金清港成品油仓储基地 油库规模一期4.4万立方米,二期扩建5.5万立方米 2020-2022 10.5 路桥金清镇黄琅剑门港
24 上虞油库(成品油) 油库规模29.7万立方米 2021-2025 9 绍兴
25 仁和油库(成品油) 扩建油库规模6万立方米 2021-2025 3 杭州
26 浙石油金华兰溪油库(成品油) 油库规模3.3万立方米 2021-2024 3 金华兰溪
27 浙石油温州油库

(成品油)

油库规模4.6万立方米 2021-2024 5 温州
28 中石化温州灵昆油库(成品油) 油库规模31.4万立方米 2018-2023 12.7 温州
29 中航油中转油库迁建项目 扩建机场油库4万立方米,新建油库6万立方米,配套输油管道约15公里 2021-2025 4 温州
30 舟山新奥LNG接收站

(二期)

建设规模为200万吨/年 2019-2021 24.1 舟山白泉
31 舟山新奥LNG接收站

(三期)

建设规模为500万吨/年 2021-2024 35 舟山白泉
32 浙江LNG接收站(三期) 建设规模为600万吨/年,配套一个码头 2021-2025 93 宁波穿山
33 浙能六横LNG接收站(一期) 建设规模为600万吨/年,配套一个码头 2021-2025 105 舟山六横
34 中石化六横LNG接收站项目(一期) 建设规模为600万吨/年,配套一个码头 2021-2025 120 舟山六横
35 温州LNG接收站

(一期)

建设规模为300万吨/年,配套一个码头 2018-2023 89.46 温州洞头
36 玉环大麦屿能源(LNG)中转储运项目(一期) 建设规模为200万吨/年,配套一个码头 2021-2025 41 玉环大麦屿
37 浙江嘉兴(平湖)LNG应急调峰储运站项目 建设规模为100万吨/年,配套一个码头 2018-2021 24 嘉兴独山港
38 温州华港LNG储运调峰中心项目(一期) 建设规模为100万吨/年,配套一个码头 2020-2023 28 温州状元岙
39 川气东送二线干线浙江段 安徽浙江省界-温州末站,管径1219mm,设计压力10MPa,总长约440公里 2021-2025 70 湖州、杭州、绍兴、台州、温州
40 川气东送二线温州-福州支干线工程 温州-浙江福建省界,管径1016mm,设计压力10MPa,长度约95公里 2022-2025 16 温州
41 甬绍干线天然气管道东段 宁波中宅-春晓-新昌,管径1219mm,

设计压力10MPa,长度约147公里

2021-2023 38 宁波、绍兴
42 甬绍干线天然气管道西段 新昌-诸暨,管径1219mm,设计压力10MPa,长度约85公里 2023-2025 22 绍兴、金华
43 杭甬复线天然气管道 宁波镇海-杭州萧山,管径1016mm,设计压力10MPa,长度约190公里 2021-2022 38 宁波、绍兴、杭州
44 西二线、川气东送嘉兴联通工程 管径1016mm,设计压力10MPa,长度约20公里 2021-2022 3 嘉兴
45 浙沪天然气联络线二期工程 管径813mm,设计压力6.3MPa,长度约45公里 2020-2021 7 嘉兴
46 六横-春晓天然气管道 舟山六横-宁波春晓,管径1016mm双管,设计压力10MPa,单管长度约33公里 2021-2025 20 舟山、宁波
47 温州LNG接收站项目外输管道 小门岛温州LNG接收站连接至乐清登陆站,管径1016mm,设计压力10MPa,长度约26公里 2021-2022 12 温州
48 温州华港LNG项目外输管道 温州状元岙华港LNG接收站连接至乐清登陆站,管径1016mm,设计压力10MPa,长度约34公里 2021-2022 15 温州
49 乐清-温州天然气管道 乐清登陆站-温州末站,管径1219mm,设计压力10MPa,长度约46公里 2022-2025 13 温州
50 玉环大麦屿LNG站外输管道 玉环大麦屿连接至甬台温管道清江阀室,管径1016mm,设计压力7MPa,长度约32公里 2021-2022 8 温州、台州
51 龙港—苍南天然气管道 由龙港延伸至苍南县灵溪镇境内,管径813mm,设计压力6.3MPa,长度约27公里 2022-2025 3 温州
52 云和-景宁-文成-泰顺天然气县县通项目 天然气管道,管径406mm,设计压力6.3MPa,总长约115公里 2022-2025 15 温州、丽水
53 庆元支线(天然气管道) 北起龙泉,南至庆元,管径406mm,设计压力6.3MPa,长度约60公里 2022-2025 7 丽水
54 衢州分输压气站改造项目 西二线南昌-上海支干线反输改造,衢州压气站具备双向增压 2021-2023 0.5 衢州
55 嘉兴LNG站外输管道 自嘉兴LNG站接至嘉兴大桥站,在独山港站设支线接入浙沪联络线二期,管径610mm,设计压力6.3MPa,总长约50公里 2021-2022 8 嘉兴
56 浙江舟山煤炭中转码头堆场扩建工程 新增煤炭储备能力220万吨 2022-2025 54.5 舟山
57 温州港乐清湾港区通用作业(C区)一期工程 新增煤炭储备能力90万吨 2019-2023 29 温州
58 台州港头门港区二期工程 新增煤炭储备能力16.9万吨 2017-2021 16 台州
二、开工项目
1 算山/镇海-中金管道 成品油管道,算山油库—镇海炼化二期—宁波油库—中金分输站,长度约45公里 2024-2027 4 宁波
2 中石化算山成品油储备基地 成品油油库库容120万立方米,原油油库库容40万方 2019-2026 28 宁波北仑
3 大榭原油地下洞库(二期) 扩建库容200万立方米 2023-2030 15 宁波大榭
4 衢山LNG接收站 建设规模为300万吨/年,配套一个码头 待定 67 舟山
5 衢山LNG接收站外输管道 衢山岛至宁波,管径1016mm,设计压力10MPa,长度约110公里 待定 50 舟山
三、前期项目
1 虾峙岛—东/西白莲—六横原油管道 长度20公里,输送量为1500万吨/年 2025-2030 6 舟山
2 杭州-湖州-皖成品油管道 余杭仁和油库至湖州苏台山油库至长兴油库到浙江安徽交界处,总长约200公里 待定 20 杭州、湖州
3 大榭石化-算山段成品油管道 大榭石化-算山首站,长度约28公里 待定 3 宁波
4 陈山-仁和成品油管道 陈山油库-仁和油库,长度约150公里 待定 8 嘉兴、杭州
5 瑞安-苍南成品油管道 甬台温瑞安末站-浙闽交界处,长度约86公里 待定 6 温州
6 中奥能源虾峙地下库 油库规模700万立方米 2025-2030 50 舟山虾峙
7 金塘储运基地(二期) 油库规模460万立方米 2025-2030 30 舟山金塘
8 双子山油品储运基地 油库规模100万立方米 2025-2030 24 舟山双子山
9 东白莲岛油品储运工程(二期) 油库规模360万立方米 2025-2030 40 舟山虾峙
10 金华油库(成品油) 油库规模12万立方米 待定 6 金华
11 台州中石油油库(成品油) 油库规模10万立方米 待定 5 台州
12 浙江LNG接收站(四期) 新增规模300万吨/年 2025-2030 30 宁波穿山
13 温州LNG接收站

(二期)

新增规模400-600万吨/年 2025-2030 40 温州洞头
14 台金衢天然气干线 横溪-缙云-遂昌-龙游,管径为1016mm,设计压力10MPa,长度为200公里 待定 50 台州、金华、丽水、衢州
15 浙能平湖独山港环保能源二期煤场 新增煤炭储备能力1.9万吨 待定   嘉兴平湖
四、谋划项目
1 浙能六横LNG接收站项目(二期) 二期建设规模600万吨/年 2025-2030 55 舟山六横
2 中石化六横LNG接收站项目(二期) 二期建设规模900万吨/年 2025-2030 65 舟山六横
3 台州头门港LNG接收站 建设规模为300万吨/年,配套一个码头 待定 59 台州头门港
4 头门港LNG接收站外输管道 头门港至甬台温三门站,管径813mm,设计压力6.3MPa,长度约85公里 待定 25 台州
5 黄泽作业区—漕泾原油海底管道 长度为90公里,输送量2700万吨/年 待定 22.44 舟山、上海
6 龙游-丽水成品油管道 龙游油库-丽水油库,长度约150公里 2025-2030 7.5 衢州、丽水
7 温州-丽水成品油管道 甬台温管道温州分输站-莲都油库,长度约210公里 2025-2030 11.5 温州、丽水

Articles and resources

References

  1. Zhejiang Province Development and Reform Commission (February 2021). "浙江省能源发展"十四五"规划" (PDF). The People's Government of Zhejiang Province. Retrieved 28 September 2021.{{cite web}}: CS1 maint: url-status (link)
  2. "350亿方!天然气年增20%如何实现!浙江这份新规划给出答案". 国际能源网. 2021-03-01. Retrieved 28 September 2021.{{cite web}}: CS1 maint: url-status (link)
  3. 3.00 3.01 3.02 3.03 3.04 3.05 3.06 3.07 3.08 3.09 3.10 3.11 3.12 3.13 3.14 3.15 3.16 3.17 3.18 3.19 3.20 3.21 3.22 3.23 3.24 3.25 3.26 3.27 The People's Government of Zhejiang Province (2021-06-01). "省发展改革委 省能源局关于印发《浙江省煤炭石油天然气发展"十四五"规划》的通知". www.zj.gov.cn. Retrieved 2021-09-23.{{cite web}}: CS1 maint: url-status (link)
  4. Zhejiang Energy Group CP LTD. "天然气 - 浙江省能源集团有限公司". zjenergy. Retrieved 2021-09-27.{{cite web}}: CS1 maint: url-status (link)
  5. "浙江天然气管网融入国家管网". www.zj.gov.cn. 2022-07-13.{{cite web}}: CS1 maint: url-status (link)
  6. 6.0 6.1 6.2 6.3 6.4 6.5 6.6 "浙江省公共资源交易-甬台温天然气输气管道工程-材料甬台温天然气管道工程苍南支线、浙沪天然气联络线一期工程、上虞新昌天然气管道工程站控系统采购甬台温天然气输气管道工程-材料甬台温天然气管道工程苍南支线、浙沪天然气联络线一期工程、上虞新昌天然气管道工程站控系统采购[E3300000001000579004001]第1次补充说明". 浙江省公共资源交易中心电子招投标交易平台. 2017-10-17. Retrieved 2021-09-22.{{cite web}}: CS1 maint: url-status (link)
  7. 7.0 7.1 "绍兴市能源发展"十三五"规划". Shaoxing People's Government. 2021-06-03. Retrieved 2021-09-23.{{cite web}}: CS1 maint: url-status (link)
  8. "上虞-新昌天然气管道工程". 原创力文档. 2016-01-29. Retrieved 2021-09-22.{{cite web}}: CS1 maint: url-status (link)
  9. 9.0 9.1 9.2 9.3 "萧山—义乌天然气管道开建!". sohu.com. 2019-04-01. Retrieved 2021-09-23.{{cite web}}: CS1 maint: url-status (link)
  10. 网易 (2021-03-12). "萧山至义乌天然气管道工程". 163. Retrieved 2021-09-23.{{cite web}}: CS1 maint: url-status (link)
  11. 11.0 11.1 "萧山—义乌天然气管道工程投产通气全省"一环网"全面建成". fzggw.zj.gov.cn. 2022-07-12. Retrieved 2022-08-18.{{cite web}}: CS1 maint: url-status (link)
  12. "丽水境内天然气长输管道实现"县县通"-浙江新闻-浙江在线". zjnews.com. 2021-02-02. Retrieved 2021-09-27.{{cite web}}: CS1 maint: url-status (link)
  13. 13.0 13.1 "丽水-龙游天然气管道一期工程初步设计获批". Gas.IN-EN.com. 2017-09-21. Retrieved 2021-09-23.{{cite web}}: CS1 maint: url-status (link)
  14. 14.0 14.1 14.2 "丽水至龙游天然气管道一期工程投产通气". The People's Government of Zhejiang Province. 2020-11-19. Retrieved 2021-09-23.{{cite web}}: CS1 maint: url-status (link)
  15. 15.0 15.1 15.2 15.3 15.4 15.5 15.6 “川气”昨天顺利进入浙江 将弥补我省供气不足现象, 浙江在线新闻网站, 2010-01-21
  16. 16.0 16.1 "关于拟对三门-嵊州天然气管道工程审批意见的公告". Gas.IN-EN.com. 2018-02-07. Retrieved 2021-09-28.{{cite web}}: CS1 maint: url-status (link)
  17. 17.0 17.1 17.2 17.3 "零的突破!三门-嵊州天然气管道工程新昌段开工". zj.zjol.com.cn. 2018-09-07. Retrieved 2021-09-27.{{cite web}}: CS1 maint: url-status (link)
  18. 18.0 18.1 18.2 18.3 18.4 18.5 18.6 18.7 18.8 18.9 "首页政务公开政务服务数据开放政民互动了解浙江". The People's Government of Zhejiang Province. 2021-06-01. Retrieved 2021-09-22.{{cite web}}: CS1 maint: url-status (link)
  19. 19.0 19.1 21亿!浙江新中标隧道项目, 搜狐网, 2024-09-13
  20. 我院编制的《甬绍干线天然气管道西段工程对浙江诸暨东白山省级自然保护区生物多样性影响评价报告》通过专家评审, 华东调查规划院, 2024-08-01
  21. 21.0 21.1 21.2 21.3 "省级天然气管网总里程突破2000公里! "县县通"云和-龙泉段正式投产通气_运行". Sohu.com. 2021-01-28. Retrieved 2021-09-23.{{cite web}}: CS1 maint: url-status (link)
  22. 22.0 22.1 "丽水境内天然气长输管道实现"县县通"". 浙江新闻. 2021-02-02. Retrieved 2021-09-28.{{cite web}}: CS1 maint: url-status (link)
  23. 23.0 23.1 "云和-龙泉天然气管道建设工程(龙泉段)快速推进-国际燃气网". Gas.IN-EN.com. 2019-08-13. Retrieved 2021-09-26.{{cite web}}: CS1 maint: url-status (link)
  24. 24.0 24.1 "丽水市云和—龙泉天然气管道工程获省发改委核准-新闻-能源资讯-中国能源网". www.china5e.com. Retrieved 2021-09-26.
  25. "大喜事!雲和-龍泉天然氣管道建設工程(龍泉段)正式開工啦!". kknews.cc. 2018-03-31. Retrieved 2021-09-28.{{cite web}}: CS1 maint: url-status (link)
  26. 26.0 26.1 "省级天然气管网总里程突破2000公里! "县县通"云和-龙泉段正式投产通气_运行". www.sohu.com. Retrieved 2021-09-26.
  27. "关于天然气"县县通"专项行动和互联互通重点工程,浙江省是这样做的(内附通知全文)_建设". www.sohu.com. 2019-06-25. Retrieved 2021-09-27.{{cite web}}: CS1 maint: url-status (link)
  28. 28.0 28.1 28.2 28.3 "西气东输管道公司油气管网设施基本情况表" (PDF). cnpc.com. Retrieved 2021-09-21.{{cite web}}: CS1 maint: url-status (link)
  29. 29.0 29.1 "中国证实东海春晓油气田投产_资讯_凤凰新媒体". news.ifeng.com. Retrieved 2021-09-27.
  30. "张国宝视察春晓油气田 1期工程进开发生产阶段-搜狐财经". business.sohu.com. Retrieved 2021-09-27.
  31. "中国证实东海春晓油气田投产_资讯_凤凰新媒体". news.ifeng.com. Retrieved 2021-09-27.
  32. 32.0 32.1 32.2 32.3 "重大信息公开 - 浙江省能源集团有限公司". www.zjenergy.com.cn. Retrieved 2021-09-27.
  33. 杭州 —湖州天然气输气管道工程建设, 《天然气和石油》,2004-09
  34. 34.0 34.1 34.2 34.3 "重大信息公开 - 浙江省能源集团有限公司". www.zjenergy.com.cn. Retrieved 2021-09-27.
  35. 杭甬天然气管道6月动工兴建 年供气26亿立方, 新浪财经,2004-05-09
  36. 36.0 36.1 绍兴市推进高水平交通强市基础设施建设三年行动计划, 道客巴巴, 2021-09-24
  37. 37.0 37.1 37.2 "浙江又一重大能源战略项目:甬台温输油气管道工程动工_新蓝网". n.cztv.com. Retrieved 2021-09-27.
  38. 石油天然气管道第三方施工作业审核意见表, 乐清市发展和改革局,2020-12-14
  39. 39.0 39.1 "甬台温天然气输气管道全线通气 沿海大通道全线贯通-浙江工人日报网". www.zjgrrb.com. Retrieved 2021-09-27.
  40. 据悉,整个甬台温天然气输气管道工程全线长419.8公里,途经宁波, 浙江在线, 2017-05-24
  41. 41.0 41.1 41.2 41.3 41.4 甬台温天然气输气管道工程(龙湾电厂支线、苍南支线)环境影响评价公示, 浙江省天然气开发有限公司,2021-10-26
  42. 42.0 42.1 甬台温天然气管道苍南支线全线贯通, 中国石油管道局, 2019-12-23
  43. 43.0 43.1 43.2 43.3 "金丽温输气管道工程全线通气投产". cpecc.cnpc.com.cn. Retrieved 2021-09-27.
  44. "金丽温输气管道工程全线通气投产 China Petroleum Engineering & Construction Corporation Southwest Company". cpecc.cnpc.com. 2018-10-10. Retrieved 2021-09-28.{{cite web}}: CS1 maint: url-status (link)
  45. 打通天然气进城“最后一公里”, 浙江省人民政府网, 2015-09-16
  46. 46.00 46.01 46.02 46.03 46.04 46.05 46.06 46.07 46.08 46.09 46.10 浙江省天然气开发有限公司关于天然气管网设施信息公开的公告, 浙江省天然气开发有限公司, 2018-06
  47. 47.0 47.1 47.2 47.3 金丽温省级天然气管道金衢段配套管道工程义乌支线项目环境影响报告书(简写本), 浙江省环境保护科学设计研究院, 2009-11
  48. 48.0 48.1 48.2 48.3 金丽温省级天然气管道金衢段配套管道工程常山支线、 江山支线及龙游支线项目环境影响报告书(简写本), 浙江省环境保护科学设计研究院, 2011-05
  49. 49.0 49.1 49.2 49.3 金丽温省级天然气管道金衢段配套管道工程金华燃机支线及兰溪支线项目变更环境影响评价(重新报批)公示, 浙江政务服务网, 2018-08-16
  50. 金丽温省级天然气管道金衢段配套管道工程金华燃机支线及兰溪支线项目变更环境影响报告书, 浙江金衢丽天然气有限公司 , 2018-08-16
  51. 金华两项省级天然气管道工程部分支线已完成建设,金华新闻网,2015-02-10
  52. 52.0 52.1 52.2 52.3 金丽温省级天然气管道金衢段配套管道工程浦江支线及东阳支线项目环境影响报告书(简写本), 浙江省环境保护科学设计研究院, 2011-05
  53. 53.0 53.1 浙江省天然气“县县通”工程东阳支线全线通气, 财经圈, 2018-08-10
  54. 54.0 54.1 54.2 54.3 54.4 54.5 省发展改革委 省能源局关于印发《浙江省煤炭石油天然气发展“十四五”规划》的通知, 浙江省发改委, 2021-07-16
  55. 55.0 55.1 55.2 55.3 55.4 55.5 "大赢家,80亿方!新奥浙江舟山接收站外输管道,正式供气浙江省网!-国际燃气网". gas.in-en.com. Retrieved 2021-09-29.
  56. 国家管网集团工程技术创新有限公司庆元支线可行性研究技术咨询项目招标公告, 采招网, 2024-04-25
  57. 省发展改革委 省能源局关于印发《浙江省煤炭石油天然气发展“十四五”规划》的通知, 浙江省发展和改革委员会, 2021-07-07
  58. 58.0 58.1 浙沪天然气联络线工程获省发改委批复, 嘉兴市合作交流办,2014-03-04
  59. 59.0 59.1 59.2 59.3 浙沪天然气联络一期工程环境影响报告书( 公示简本), 浙江省天然气开发有限公司, 2014-07
  60. 60.0 60.1 60.2 60.3 浙沪天然气联络线二期工程环境影响报告书(报批稿), 浙江省环境科技有限公司, 2020-04
  61. 浙沪天然气联络线一期(屠甸站-海盐站)段管道正式通气, 南湖晚报, 2018-11-16
  62. 保障能源供应安全 浙沪天然气联络线二期工程开工, 浙江新闻客户端, 2020-09-24
  63. 浙江院勘察设计的浙沪天然气联络线二期工程投产, 中国能建中电工程浙江院, 2024-01-02
  64. 64.0 64.1 温州LNG接收站项目正式开工, 温州市发展和改革委员会,2018-09-20
  65. 65.0 65.1 65.2 65.3 浙江省扩大有效投资“千项万亿”工程2023年重大项目实施计划项目表, 浙江省发改委,2023-04-10
  66. 66.0 66.1 66.2 温州市发展和改革委员会关于市十四届人大三次会议第344号建议的答复函, 温州市发改委, 2023-07-17
  67. 67.0 67.1 67.2 67.3 华港LNG外输管道工程可行性研究技术服务项目-项目公告, 国家石油天然气管网集团有限公司西气东输分公司, 2021-11-05
  68. 68.0 68.1 68.2 68.3 68.4 68.5 68.6 浙江省发展改革委关于东阳—磐安天然气管道工程核准的批复, 浙江省发改委, 2017-07-14
  69. 69.0 69.1 69.2 69.3 69.4 69.5 西二线、川气东送嘉兴联通工程环境影响报告书,国家石油天然气管网集团有限公司,2022-03
  70. 西气东输管道系统为长三角一体化高质量发展注入“绿色动能”, 新华网, 2024-06-15
  71. 71.0 71.1 71.2 71.3 71.4 关于六横-春晓输气管道工程海域使用论证报告书评审前公示,浙江省自然资源厅, 2021-07-06
  72. 舟山市发展和改革委员会关于市政协八届二次会议第82007号提案的复函, 舟山市发展和改革委员会, 2023-08-27
  73. 玉环市自然资源和规划局召开重点项目农转对接会, 玉环市传媒中心, 2024-03-01
  74. 玉环两个重大民生项目,取得新进展, 玉环市传媒中心, 2023-07-06
  75. 浙江嘉兴(平湖)LNG应急调峰储运站气化外输保供管线工程站场、阀室项目工程总承包(EPC), 嘉兴市公共资源交易中心,2023-01-18
  76. 76.0 76.1 76.2 76.3 建设项目环境影响评价审批嘉兴市生态环境局对浙江嘉兴(平湖)LNG应急调峰储运站气化外输保供管线工程环评文件作出审批决定的公告], 嘉兴市生态环境局,2020-12-31
  77. 77.0 77.1 浙江嘉兴LNG应急调峰储运站气化外输高压管线正式投产, 国际能源网, 2024-03-18
  78. 台州头门港LNG接收站纳入浙江“十四五”规划 开工还要经过38道审批程序, 中国网, 2022-11-03
  79. "省发展改革委 省能源局关于印发《浙江省煤炭石油天然气发展"十四五"规划》的通知". www.ningbo.gov.cn. 2021-06-21. Retrieved 2022-09-14.{{cite web}}: CS1 maint: url-status (link)

Related GEM.wiki articles

External resources

External articles
