Xinjiang Coal-to-Gas Pipeline Project also known as (新疆煤制气外输管道 (新粤浙煤制甲烷管道) is a coal-to-gas pipeline with segments that are operating and in construction in China.[1][2]

Location

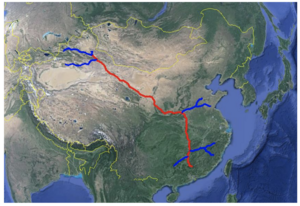

The pipeline runs from the Xinjiang Autonomous Territory to Shaoguan, Guangdong, China. It has six branch lines, reaching out Guangxi, Fujian, Zhejiang, and Shandong.[3]

Loading map...

Project Details

  • Operator: 中国石化新疆煤制天然气外输管道有限责任公司
  • Parent Company: Sinopec
  • Current Capacity: 30 billion cubic meters per year
  • Length: 8372 kilometers
  • Status: Construction[4]
  • Start year:

Background

The pipeline is included in China's 12th Five-Year Plan and the 13th Five-Year Plan.[1] It has one trunk line and five branches. It starts at Yining, Xinjiang and ends in Shaoguan, Guangdong, passing through 13 provinces in China. The total investment was estimated 159 billion yuan.[5] The source of the pipeline is the coal-to-gas facilities in Xinjiang, including 9 coal chemical plants which signed contracts with Sinopec to supply 40 billion cubic meters of coal-to-gas every year.[6] Sinopec was planning to develop additional 20 billion cubic meters of coal-to-gas to match the capacity of the pipeline.[5][7]

One source from April 2013 says the length of the pipeline is 7927 kilometers, including one trunk line (4859 kilometers) and four branches (3068 kilometers)[8]. Another source from 2021 says the pipeline includes one trunk line and six branches.[9]

The segment of Gansu entered preparing stage in 2014. No further news of it though.[10]

Sinopec expects to complete the Qianjiang-Shaoguan section by 2020.[11] In June 2020, part of the pipeline between Qianjiang, Hubei and Chenzhou, Hunan went into operation[12]. As of October 2021, the remainder continues to be under construction.

The changed Environmental Impact Assessment of Guangxi Branch was open for public review in April 2021.[9] The construction of Guangxi branch started in July 2021. [13]

Branch details

SegmentName Segment's Chinese name Status Owner Capacity Unit Length Unit diameters Unit
Ili Branch 伊犁支干线(伊犁-木垒) Proposed 国家管网集团新疆煤制天然气外输管道有限责任公司 30.00 bcm/y 793.00 km 1219.00 mm
Zhundong Branch 准东支干线(准东-木垒) Proposed 国家管网集团新疆煤制天然气外输管道有限责任公司 30.00 bcm/y 127.00 km 1219.00 mm
Nanjiang Branch 南疆支干线(库车-七角井) Proposed 国家管网集团新疆煤制天然气外输管道有限责任公司 6.00 bcm/y 862.00 km 914.00 mm
Henan-Shandong Branch 豫鲁支干线(宜阳-濮阳-临沂,濮阳-齐河) Proposed 国家管网集团新疆煤制天然气外输管道有限责任公司 15.00 bcm/y 993.00 km 1219/610 mm
Jiangxi-Fujian-Zhejiang Branch 赣闽浙支干线(株洲-抚州-江山,抚州-南平) Proposed 国家管网集团新疆煤制天然气外输管道有限责任公司 8.50 bcm/y 1002.00 km 1016/813 mm
Guangxi Branch 广西支干线(衡阳-桂林) Construction 国家管网集团新疆煤制天然气外输管道有限责任公司 70.5 bcm/y 463.00 km 800.00 mm

Articles and resources

References

  1. 1.0 1.1 中国石化潜江至韶关输气管道工程(湖南段)开工, Sina, Sep. 28, 2017
  2. 新疆煤制气外输管道项目四年后终获批 October 16, 2015
  3. 中国石化新疆煤制气外输管道工程(新粤浙管道)环境影响报告书 Ministry of Ecology and Environment of People’s Republic of China, April 2015
  4. 国内煤炭基地和煤电基地, 今日头条, 2023-11-04
  5. 5.0 5.1 "新粤浙管道工程_百度百科". 百度百科.{{cite web}}: CS1 maint: url-status (link)
  6. "新粤浙与新鲁输气管道将开建_新闻台_中国网络电视台". news.cntv.cn. 2012-01-02.{{cite web}}: CS1 maint: url-status (link)
  7. "中石化新粤浙管道工程获得"路条" 总投资1,590亿元--报载". 中国财经--Reuters. 2012-10-18.
  8. "中石化将在新疆准东建世界最大规模煤制气基地". www.gov.cn. 2013-04-07.{{cite web}}: CS1 maint: url-status (link)
  9. 9.0 9.1 "2021年4月28日生态环境部关于新疆煤制气外输管道工程(新粤浙管道)广西支干线段变更等2项环境影响评价文件拟进行审查公示_中华人民共和国生态环境部". www.mee.gov.cn. 2021-04-28.{{cite web}}: CS1 maint: url-status (link)
  10. "中国石化新疆煤制天然气外输管道工程新粤浙管道甘肃段社会稳定风险分析公众参与信息公示". www.sohu.com. 2017-08-15.{{cite web}}: CS1 maint: url-status (link)
  11. 中石化最大单体工程一期项目或明年投产 投资超千亿, Sina, Sep. 23, 2019
  12. 湖南首条国家天然气干线管道正式投产进气 红网,June 25, 2020
  13. "抢抓机遇 油气管网基础设施建设跑出加速- 来源:国家管网集团-上海石油天然气交易中心". www.shpgx.com. 2021-08-26.{{cite web}}: CS1 maint: url-status (link)

Related GEM.wiki articles

External resources

External articles
